Fibre Optic Symphonic Orchestra (FOSO) – Wentworth, NSW

Inspired by the arrangement of Hills Hoist clotheslines resembling an orchestra pit, each adorned with fibre optic lights representing different musical instruments, FOSO transforms this setup into a symphonic visual and auditory experience. The installation is synchronised with an original orchestral score composed by the renowned British composer Nainita Desai, elevating the viewer’s interaction with the art.

Comprising 80 columns of light made from cylindrical arrays of fibre optic cables, encircling an iconic rotary structure measuring 3.5 meters high and 4 meters in diameter, FOSO captivates visitors with its dynamic interplay of colour and sound. The lights are programmed to change hues in harmony with the musical composition, guiding visitors through a labyrinthine path of abstract light patterns that respond in real-time to the music.

The colour palette of FOSO is intricately designed to correspond with the notes of an octave, utilising a rainbow spectrum to visually interpret the music being played. This thoughtful integration of light and sound offers a multisensory journey, inviting exploration and immersion into the artistic fusion of Australian heritage, technological innovation, and creative expression.

For those seeking a profound cultural experience in regional NSW, FOSO promises an unforgettable encounter with contemporary art and sensory exploration. It represents an opportunity to engage deeply with the intersection of light, music, and landscape, making it a must-see for enthusiasts of art and cultural innovation alike.

FOSO is part of the broader LightState project, which aims to bring innovative art experiences to various regions. This collaborative effort extends beyond Wentworth, with a sister installation titled Trail of Lights on Lock Island in Mildura. Together, these installations serve as beacons of creativity and inspiration, enriching the cultural fabric of New South Wales, Victoria and beyond.

Find out more at Trail of Lights (Mildura.com)

Fibre Optic Symphonic Orchestra

FOSO Sensorio 2025 Bruce Munro. Photography by Serena Munro.

Project Site

FOSO is set to be located 4 kilometres from the township of Wentworth, adjacent to the ancient Perry Sandhills and Thegoa Lagoon. Due to the unique nature of the sandhills, they have been used as a backdrop in many films and television shows. According to geologists, the Perry Sandhills originated after an ice age (40,000 years ago) and are formed by wind erosion over thousands of years.


Perry Sandhills

Funding

The realisation of this remarkable experience is made possible through the generous support from the New South Wales Government – Regional Tourism Activation Fund (RTAF) $4.9 million.

Their contribution plays a vital role in bringing this immersive and captivating experience to life, enriching the cultural landscape, and fostering tourism and development in the region.


Project Inspiration

Bruce Munro’s Inspiration

“When I was 21 years old, I read a book called ‘Gifts of Unknown Things’ by Lyall Watson, a radical thinker operating on the margins of accepted science. In it Watson described Tia, a young girl living in the Indonesian archipelago, who possessed the magical gift of seeing sounds in colour, which I later learned is called “synaesthesia”.

It is a neurological condition in which, when one sense is activated, another unrelated sense is also activated – for instance, when a person hears music and simultaneously “sees” the sound as swirls or patterns of colour.

I was captivated by the idea of a connection between sound and colour from that day forward and have worked with the notion of a human form represented as abstracted cylinders of light in a number of ways. I first used it in a private commission made to commemorate a couple’s sixtieth wedding anniversary in 2006; and in 2010, as a fundamental concept for the installation Water-Towers. The idea of creating an orchestra of lighted columns has been lying wait in my sketchbook since 2011.

The stunning location presents the opportunity to create another community of sound, differently than I had before: an abstract installation of an entire light-responsive Symphonic Orchestra. In this installation, eighty, three and a half meter high, four-meter diameter light installations, each being a “musician,” will form the physical plan of an orchestra.

Each musician is represented by the iconic Hill’s Hoist rotary washing line, an everyday Australian object that is also a beautiful structural support to my mind. Cylindrical arrays of fibre optic cables will encircle each Hills Hoist, making it a column of light.

A control system will scroll through a rainbow of colours synchronised with a symphonic soundtrack. As the fibre optic columns change hues, viewers will experience sound translated into colour.

This installation is the result of concepts and techniques developed over a number of years and evolved from many previous works”.

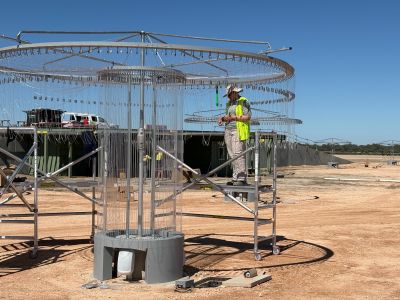

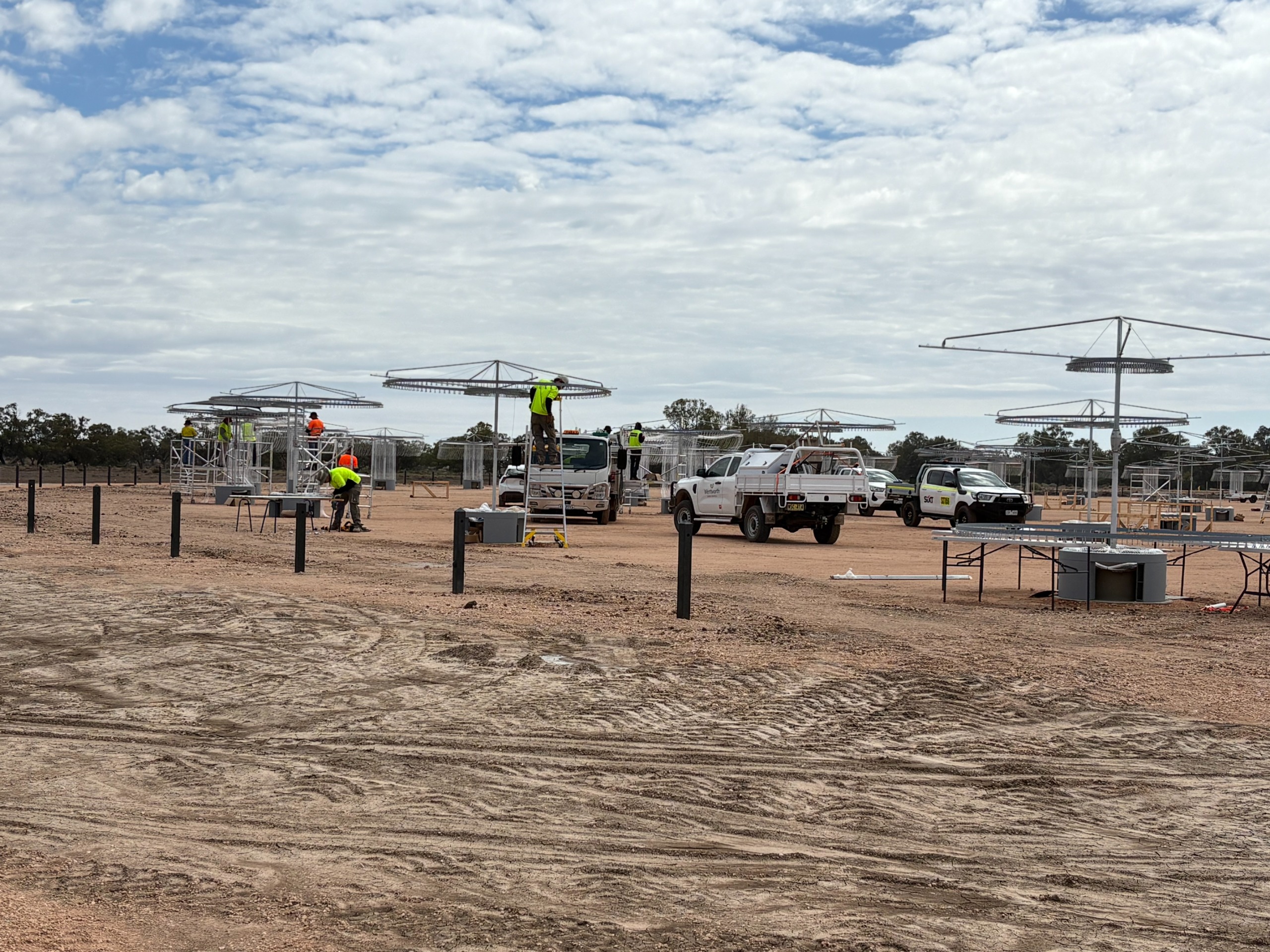

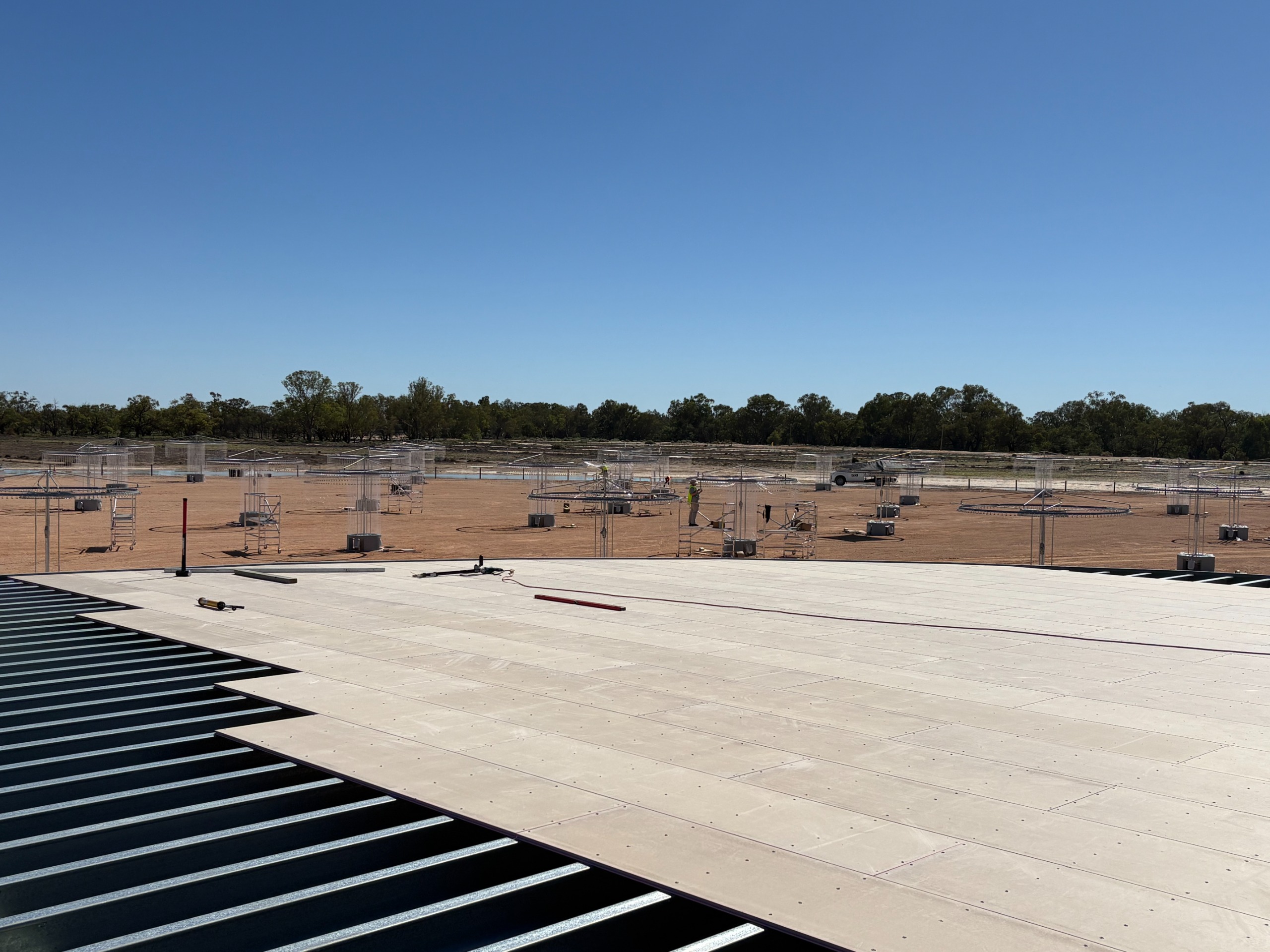

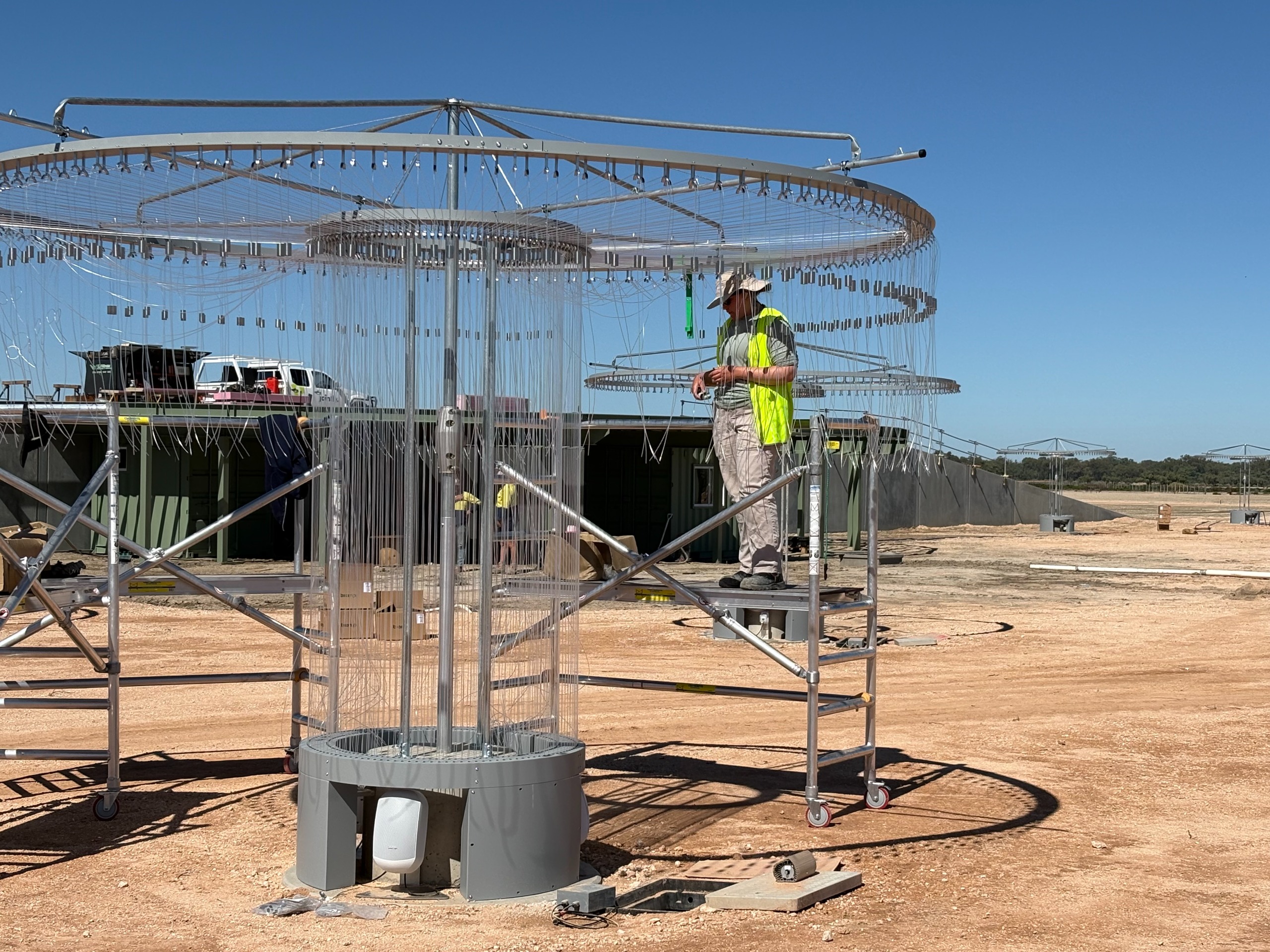

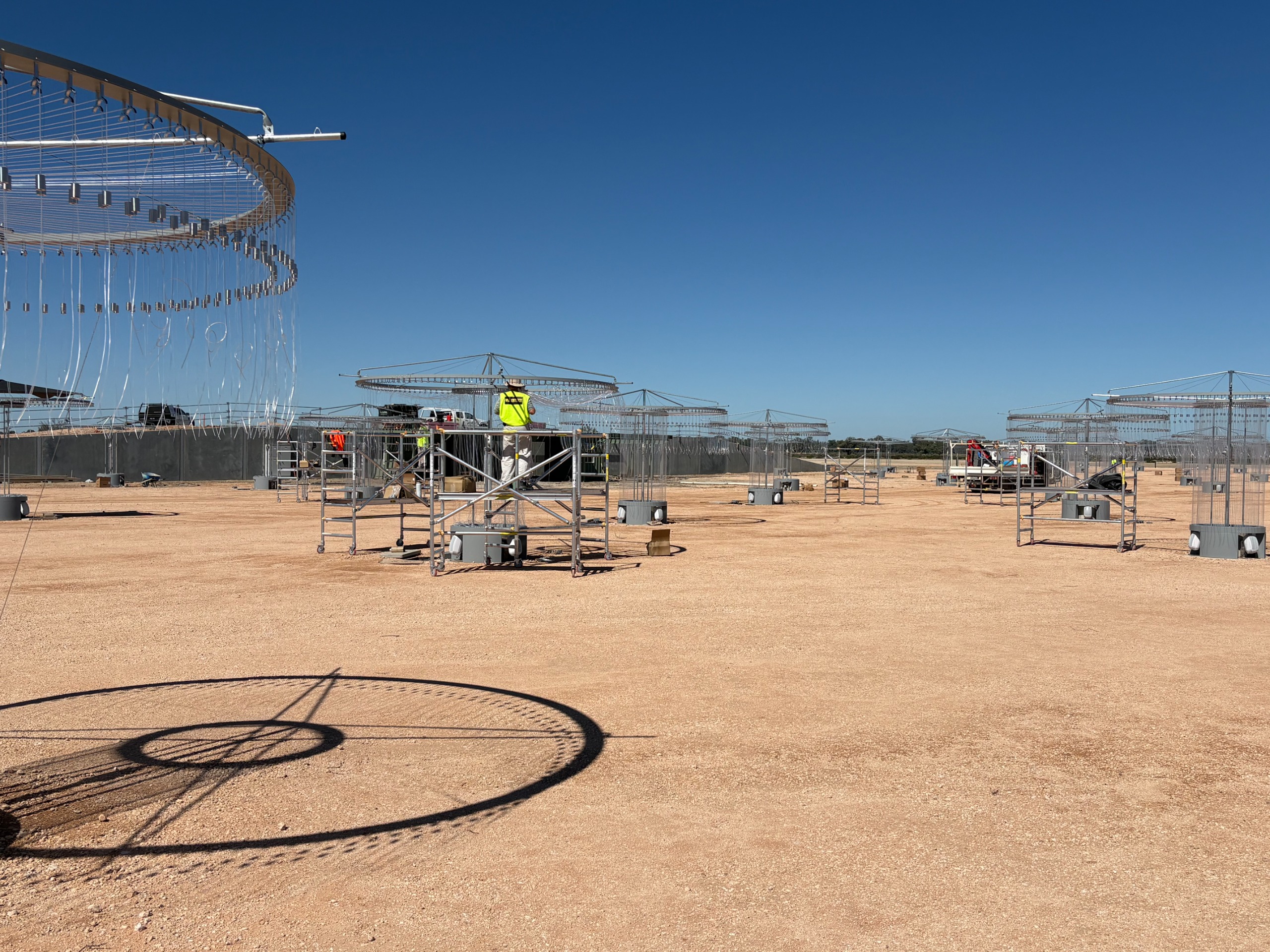

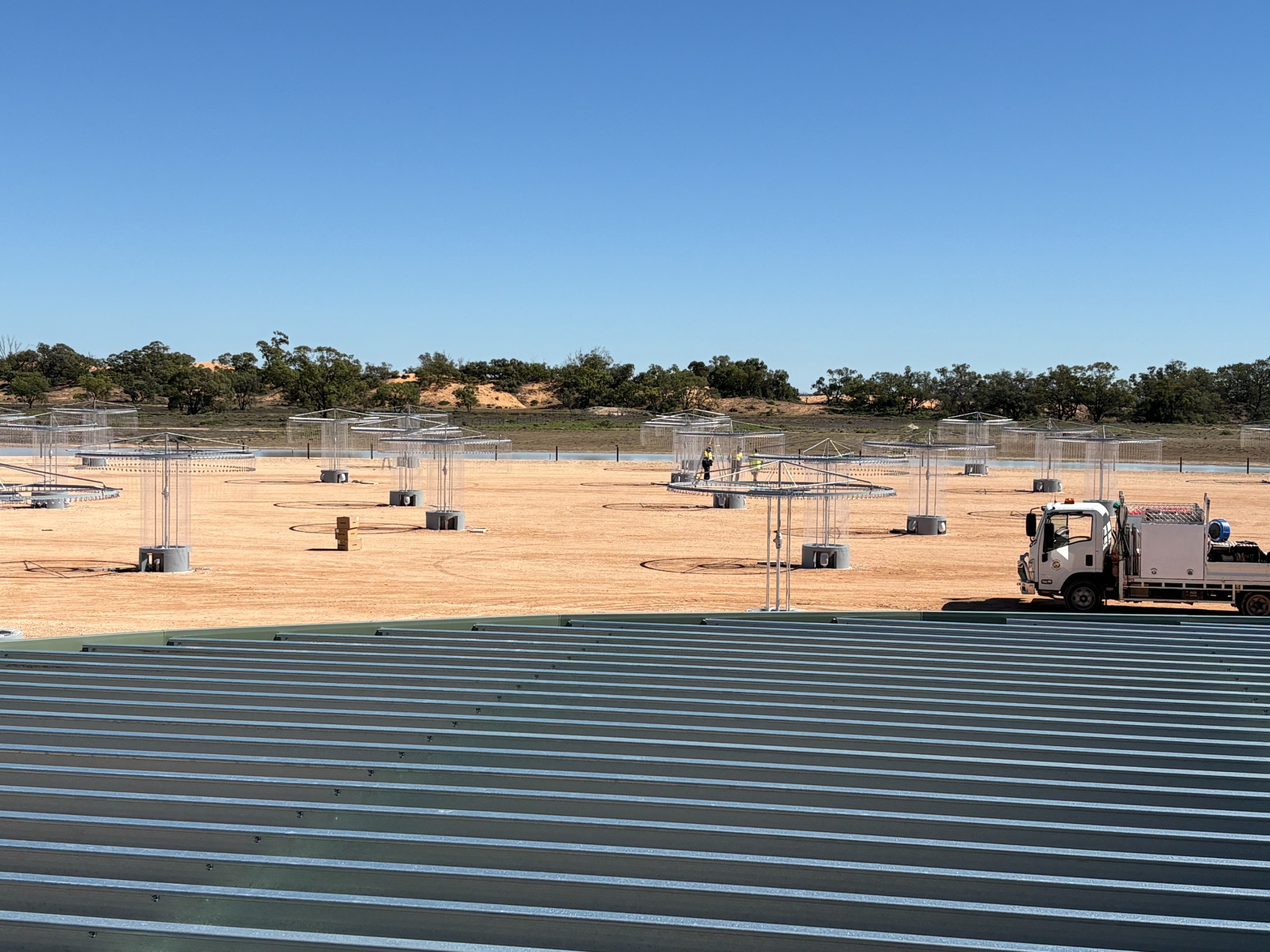

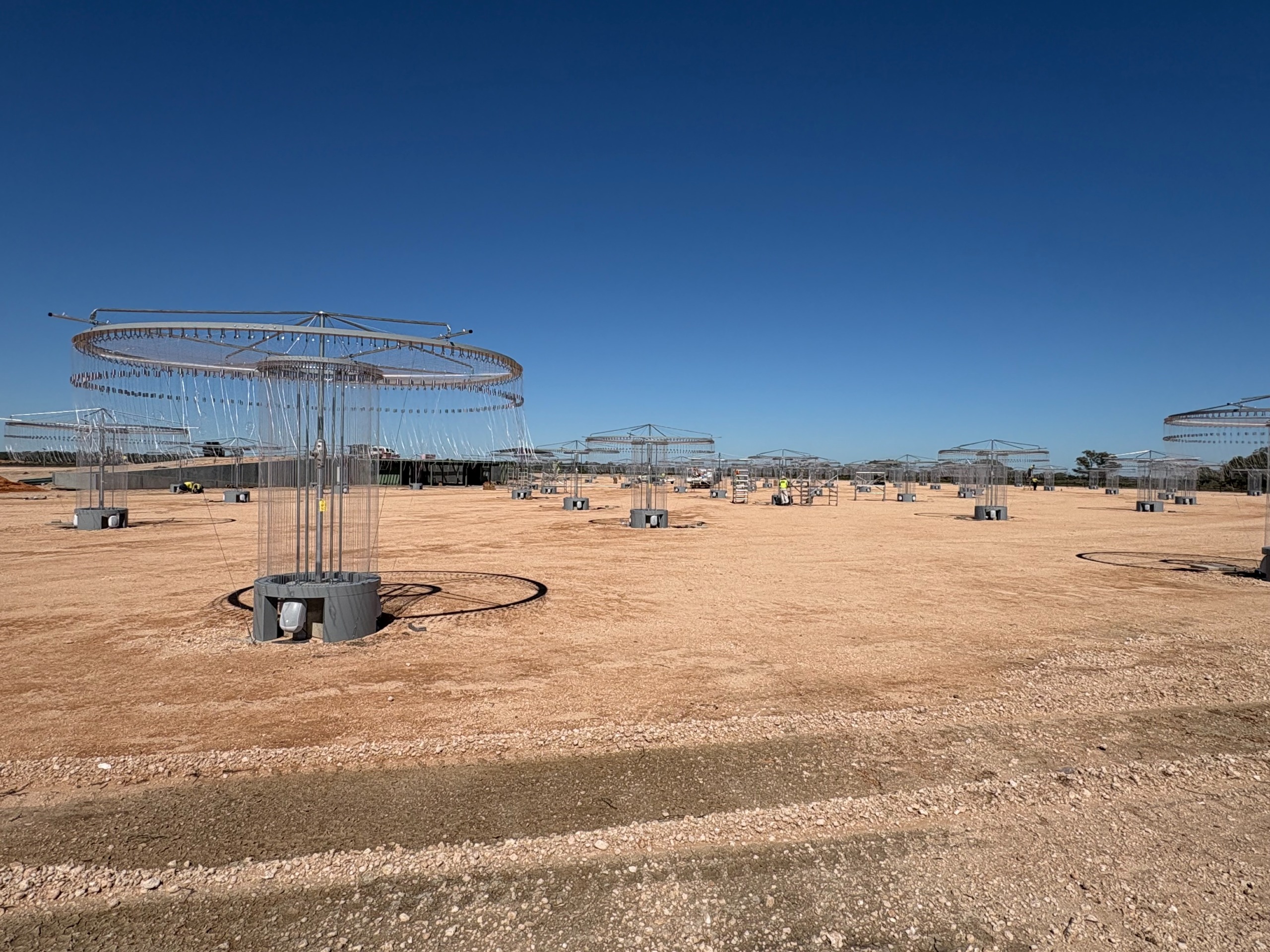

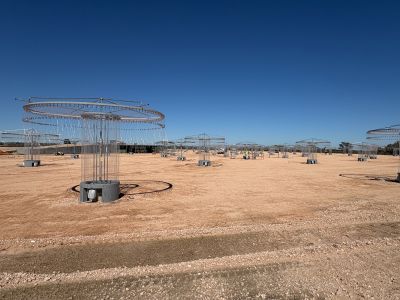

Timeline

  • Timeline item 1 - complete

    Construction is officially underway on Fibre Optic Symphonic Orchestra (FOSO)

  • Timeline item 2 - complete

    Site Mobilisation

    Erect Site Fencing

    Install Temp Facilities

    Install Temp Power

    Site Setout/Surveying

    Remove Redundant Existing Fencing

  • Timeline item 3 - complete

    Site Works

    Inground Services.

  • Timeline item 4 - complete

    Civil Works - Initial Site Prep

    Prep Works (Float Equipment)

    Site Cut/Scrape back topsoil

    Condition/Compact Existing Subgrade

    Import Road/Access Path Material

    Install subbase layer to roadways

  • Timeline item 5 - complete

    Civil Works - Event Space/Platform Prep

    Prep Works

    Site Cut/Scrape back topsoil

    Condition/Compact Existing Subgrade

    Excavate Basin when soil is required, recompact

    Install subbase layer to roadways

  • Timeline item 6 - complete

    Retaining Wall Installation

    Site Setout

    Footing/Steel Installation

    Panel Installation

    Structural Inspection Signoff

  • Timeline item 7 - complete

    Civil Drainage

    Install RCP Pipework, Headwalls, Wall drainage e…

  • Timeline item 8 - complete

    Civil Works - Southern Raised Viewing Platform

    Excavate Basin and fill platform

    Install subbase layer to roadways

    Final Trim/Compact

  • Timeline item 9 - active

    Electrical Services

    MSB & Underground Consumer Mains to pole

    Underground Lighting Field Conduit Install x 80

    General Site Undergrounds

  • Timeline item 10 - active

    Hydraulic Services

    Stormwater/Sewer Installation

    Pump Pit

  • Timeline item 11 - active

    Civil Works - Final Trim/Makegood

    Spoil Removal/Management

    Makegood of lighting field footprint

    Makegood all roads/carparks

    Final Trim of Retention Basin

  • Timeline item 12 - active

    Concrete Works

    Lower-Level Container Footings

    Upper-Level Container Footings

    Footpaths-General Access

    Artwork - Concrete Base Formwork Install

    Artwork - Concrete Base Pour

  • Timeline item 13 - active

    Site Works -Above ground

    Electrical Meter Connection/Permanent Power

    Internal DB Installation

    Site Testing & Commission Post Powerup

    AV Cable Haul

    Bollard/Carpark Lighting Install

    Portable Building Connections

  • Timeline item 14 - incomplete

    Hydraulic Services

    Rainwater/Waste Tank Installation

    Pump Installation

    Heating & HWS Install

    Portable Building Connections


  • Timeline item 15 - active

    Portables Installation

    Delivery & Cranage

    Electrical Fit off

    Hydraulic Fit off

    Furniture Fit out

  • Timeline item 16 - active

    External Works

    Perimeter Fencing

    General Bollard Installation

    Signage Installation

  • Timeline item 17 - active

    BM Studio Associated Works

    Build and Install Hills Hoist x80

    Cabling/Commissioning

    AV install

    AV Room Install - TBC

  • Timeline item 18 - incomplete

    Site Demobilisation

    Initial Defects Walk

    Builders Clean - Building

    Final Defects Walk

    Contingency

  • Timeline item 19 - incomplete

    Site Handover - 24 April 2026
